The ASTM E1155 standard defines how floor flatness (FF) and floor levelness (FL) are measured and reported in concrete construction. It gives engineers, contractors, and inspectors a consistent way to quantify how smooth or uneven a floor is. Understanding this system is vital for meeting project specifications, avoiding costly rework, and ensuring that finished floors perform as intended especially for warehouses, hospitals, and high-precision manufacturing spaces where tolerances matter most.
This article breaks down what the F-Number system means, how FF and FL are calculated, why these values matter for quality control, and how to maintain compliance under ASTM E1155 from pour to project closeout.
Understanding the Purpose of ASTM E1155
Before the F-Number system existed, contractors relied on a simple “straightedge” test using a 10-foot ruler to check floor flatness. While practical, that method lacked precision and consistency. ASTM E1155 introduced a mathematical approach that measures variations in elevation across multiple points on the slab, producing repeatable numbers that represent surface smoothness and levelness.
The key goal of ASTM E1155 is to standardize how concrete floors are evaluated. It ensures every party from the concrete finisher to the project manager uses the same language when discussing tolerances.
Why FF and FL Matter
- FF (Floor Flatness): Measures the smoothness of the surface. A higher FF value means the surface has fewer bumps or dips. It primarily affects the movement of small-wheeled equipment like forklifts or hospital carts.
- FL (Floor Levelness): Measures how close the overall surface is to a true horizontal plane. High FL numbers mean less slope or tilt across large distances.
Both numbers are dimensionless indices derived from elevation data taken at fixed intervals along measurement lines. Together, they describe a floor’s geometry one focusing on short-range smoothness, the other on long-range slope.
How the F-Number System Works
The F-Number system assigns two separate ratings FF and FL to every measured area. ASTM E1155 describes the exact statistical process used to compute them, making it possible to compare performance across projects.
In simple terms, the higher the F-Number, the better the floor.
Step-by-Step Measurement Process
- Survey Setup
A grid or set of parallel lines is marked on the floor. Measurements are taken at regular intervals, typically every 12 inches along each line. - Data Collection
A precision instrument such as a digital level or laser profiler records the relative elevation at each point. - Difference Calculation
The elevation difference between consecutive points determines the short-range variation (for FF) and long-range slope (for FL). - Statistical Analysis
The standard deviation of those differences is multiplied by constants defined in ASTM E1155 to produce the final F-Numbers. - Reporting
FF and FL values are reported separately for each test section and averaged across the total floor area.
Typical results might read:
FF 45 / FL 35 (Overall Average)
Contractors must meet both the minimum local and overall F-Numbers specified in project documents to pass inspection.
Common Tolerance Targets
| Floor Type | Typical FF / FL Range | Application Example |
| Conventional Slab-on-Grade | FF 25 / FL 20 | Standard industrial floors |
| Moderately Flat | FF 35 / FL 25 | Retail or commercial spaces |
| Superflat | FF 50 + / FL 35 + | High-bay warehouses, robotic facilities |
These target ranges vary depending on project specifications and whether the floor supports rack-guided equipment or precision machinery.

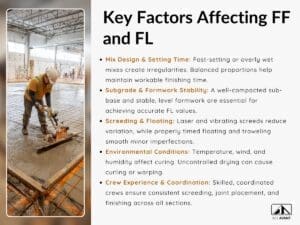

Key Factors Affecting FF and FL
Even with skilled crews and strict procedures, many elements can influence final floor tolerances. Understanding them helps in planning placement techniques and post-pour corrections.

1. Mix Design and Setting Time
Concrete that sets too quickly reduces finishing time and increases surface irregularities. Conversely, overly wet mixes may lead to differential settlement. Proper mix proportions and additives help achieve a workable balance.
2. Subgrade and Formwork Stability
The sub-base must be uniformly compacted. Any uneven support transfers to the slab above, lowering FL values. Rigid formwork, accurately staked and levelled, provides the foundation for achieving a level slab.
3. Screeding and Floating
Laser screeds and vibrating screeds have largely replaced manual straightedge tools. They maintain consistent elevation and minimize variation along the pour. Floating and troweling must occur at the correct time to smooth minor irregularities without pulling moisture to the surface.
4. Environmental Conditions
Temperature swings, wind, and humidity all affect curing and finishing. Sudden drying may cause warping or curl, especially at slab edges. Controlling ambient conditions with windbreaks or misting improves uniformity.
5. Crew Experience and Coordination
Flatness and levelness are as much about teamwork as they are about tools. A well-coordinated crew communicates about screed passes, joint placement, and finishing timing to prevent inconsistencies between sections.
High FF and FL values result from consistent mix quality, stable support, and well-timed finishing operations.
Measuring Floor Tolerances on Site
ASTM E1155 provides detailed instructions for taking measurements after concrete placement. The process usually occurs within 72 hours of finishing, before significant shrinkage or curling alters the surface.
H3: Equipment and Methodology
- Tools: Digital profiler, electronic level, or laser device accurate to ±0.01 inch.
- Grid Layout: Measurement lines spaced 10 feet apart with elevation points every 12 inches.
- Data Quantity: At least two measurement lines for each 5,000 sq ft section of floor.
- Recording: Readings are logged sequentially, and differences are processed using the ASTM formula.
The results are analyzed by software or spreadsheet templates based on the equations in ASTM E1155 Section 9. Field engineers calculate both the local (single test section) and overall (entire floor) F-Numbers. If local results fall below required limits, corrective measures such as grinding or surface topping may be needed.
Interpreting FF and FL Results
Once FF and FL values are computed, they must be compared to specification requirements. A result like FF 40 / FL 32 tells engineers that the floor is moderately flat and level enough for most commercial uses. But certain facilities demand “superflat” tolerances far stricter than standard specifications.
Typical Performance Classifications
| Classification | FF / FL Range | Description |
| Ordinary | FF 20 – 25 / FL 15 – 20 | Acceptable for general construction where appearance outweighs precision |
| Flat | FF 35 – 40 / FL 25 – 30 | Suitable for commercial or light industrial floors |
| Superflat | FF 50 – 80 / FL 35 – 50 | Required for high-rack aisles, robotic systems, or sensitive equipment |
When interpreting results, remember that FF controls short-range bumps (every 2 feet), while FL controls overall slope (every 10 feet). A floor may be very smooth (high FF) but still tilt slightly (low FL). Both must meet spec to satisfy ASTM E1155 compliance.
Ensuring Quality Control During Placement
Achieving the required F-Numbers starts long before the slab hardens. Successful contractors implement real-time monitoring, crew coordination, and pre-pour planning to control surface geometry.
1. Pre-Construction Meetings
Hold meetings with structural engineers, finishers, and testing personnel to review target tolerances and testing intervals. Clarify whether ASTM E1155 or other standards such as ACI 117 govern acceptance.
2. Continuous Monitoring
Laser screeds often include onboard sensors that show elevation deviation in real time. Adjusting during placement saves time and reduces post-pour corrections.
3. Joint Layout and Sequencing
Control joints and pour strips should be planned to minimize elevation mismatch between adjacent panels. Each strip can be measured individually for FF/FL before removing the divider.
4. Post-Pour Verification
After finishing, take spot measurements to predict expected F-Numbers. These early checks guide where additional troweling or grinding might be needed before the surface cures fully.
Consistent measurement and immediate feedback keep quality within specification, preventing failed inspections later.
Comparing ASTM E1155 with ACI 117
While ASTM E1155 defines how to measure flatness and levelness, ACI 117 specifies the tolerances that must be achieved. The two standards complement each other and are often referenced together in construction documents.
| Standard | Purpose | Key Focus |
| ASTM E1155 | Describes the test method and calculation for FF and FL values | Measurement procedure |
| ACI 117 | Defines acceptable tolerance limits for construction quality | Compliance requirements |
H3: Practical Relationship on Projects
- ASTM E1155 = How to measure
- ACI 117 = How flat or level the result must be
For example, ACI 117 might specify that a floor shall achieve an overall FF 35 / FL 25, while ASTM E1155 tells inspectors exactly how to verify that claim. Both must be applied together to maintain structural and functional consistency across the project.
Challenges and Common Issues
Even when specifications are clear, achieving them consistently can be difficult. The following issues often arise on job sites:
- Slab Curling: Differential drying between top and bottom causes edges to lift, reducing FF and FL over time.
- Improper Finishing Timing: Starting troweling too soon can trap water and create uneven textures.
- Uneven Form Removal: Pulling forms before adequate curing leads to sagging edges and slope variations.
- Environmental Shifts: Sudden wind or heat can alter set times, producing rough patches or cracks.
- Measurement Errors: Skipping calibration or inconsistent data intervals yield unreliable results.
Quality control isn’t only about precision instruments it depends on consistent technique and good communication between teams.
Practical Applications of the F-Number System
The F-Number system applies across various project types, from small commercial buildings to massive distribution centers. Its importance grows with the floor’s functional demands.
1. Warehouses and Distribution Centers
Automated guided vehicles (AGVs) require extremely smooth floors to prevent vibration and sensor misalignment. Superflat floors (FF > 50) reduce maintenance costs and equipment wear.
2. Retail and Commercial Buildings
Moderately flat floors ensure visual uniformity for finishes like vinyl tile or polished concrete. They also prevent tripping hazards and make display installation easier.
3. Industrial and Manufacturing Facilities
Machines anchored to the floor need level bases to maintain precision. Consistent FL ratings minimize adjustment time during equipment setup.
4. Hospitals and Laboratories
Smooth, level surfaces are essential for hygiene and wheeled mobility. The F-Number system verifies compliance before final flooring systems are applied.
In all cases, using ASTM E1155 testing early allows corrections before expensive finishes or machinery installation begin.
Best Practices for Maintaining Compliance
To maintain compliance under ASTM E1155, consistency and documentation are essential throughout the project. Contractors and quality-control teams should adopt the following strategies.
1. Calibrate Equipment Regularly
Ensure laser levels, profilers, and straightedges are verified for accuracy before each use. Small deviations in measurement devices can alter final F-Numbers significantly.
2. Record and Archive All Data
ASTM E1155 requires retaining field measurement logs and calculation sheets as part of project records. Keeping digital copies helps with audits and warranty claims.
3. Provide Training for Field Technicians
Personnel performing FF/FL surveys must understand how to take consistent readings, identify outliers, and apply the ASTM formula correctly.
4. Integrate Quality Reviews
Include F-Number checks in project milestones such as after each pour strip to identify trends and make process improvements.
5. Coordinate with the Design Team
If achieving specified tolerances proves unrealistic due to structural constraints, communicate early. Designers can adjust requirements or approve alternative measurement zones.
Maintaining compliance is not a one-time task but a continuous quality-assurance process that extends through project completion.
Common Myths About F-Numbers
Understanding what F-Numbers do not represent is as important as knowing what they do.
- Myth: A high FF guarantees level floors.
Fact: FF measures smoothness, not overall slope. FL must also meet tolerance. - Myth: Grinding always fixes low F-Numbers.
Fact: Grinding can correct bumps but may not resolve large-scale slope variations or curl. - Myth: Once measured, F-Numbers never change.
Fact: Shrinkage and curling can alter flatness over time, so timing of measurement matters. - Myth: F-Numbers apply only to floors.
Fact: While primarily for slabs, similar measurement principles are used for pavements and elevated decks.
Dispelling these myths helps teams use the standard correctly and interpret results realistically.
Maintaining Quality and Compliance Under ACI 117
Concrete floors that meet ASTM E1155 standards demonstrate precise workmanship and proper process control. But long-term performance depends on following ACI 117 tolerances during construction and verifying results through E1155 testing. The two standards work together to define quality, measurement, and accountability.
Maintaining compliance means consistent documentation, proper calibration, and transparent reporting at every stage from mix design to final inspection. When both standards are applied together, owners gain assurance that their floors will remain durable, safe, and serviceable for years to come.
Future projects increasingly integrate digital scanning and automated profiling, offering faster verification and higher precision. As technology evolves, ASTM E1155 and ACI 117 continue to guide concrete professionals toward the same goal: a level, reliable, and high-quality floor that meets performance demands and industry expectations.
